Cost Performance Index: A Guide for Project Managers

Photo of author
By Ruaidhri Nolan on May 15, 2025
17 min read

Summary

Cost Performance Index (CPI) is a simple way to measure how efficiently a project is using its budget.

Cost Performance Index Formula:
Earned Value ÷ Actual Cost = CPI

In simple terms:
A CPI of 1 means you’re exactly on budget.
More than 1 means you’re spending less than planned (good).
Less than 1 means you’re overspending (bad).

CPI for project budget management - screendragon

Cost Performance Index (CPI) offers real-time clarity to guide project managers. As you read on, you’ll gain an understanding of how CPI works, with practical guidance on calculating, interpreting, and acting on CPI. The blog helps teams surface inefficiencies early, adjust with confidence, and align spend with impact.

For project managers managing multi-stream programs, internal agencies tracking resource value, or operations leaders aiming for financial visibility, the cost performance index becomes more of a steering mechanism for performance that holds under pressure.

What is the Cost Performance Index (CPI)?

A project initiative gets greenlit. Budgets are locked, timelines are aligned, and teams are mobilised. This is where financial clarity matters, and where the cost performance index earns its place.

CPI doesn’t just report whether a project is on budget. It tells you whether your current investment is delivering proportionate value. And it does so in a way that’s visible, quantifiable, and responsive – early enough to act, not just reflect.

For leaders running complex campaigns or managing in-house agency workflows, the cost performance index is a key project management metric that helps ensure you’re moving forward and doing so in a financially sustainable way. It’s a critical indicator of cost efficiency, helping you make faster calls on resourcing, scoping, and executive alignment. When you stay on budget, you protect strategic intent.

Introduction

The numbers might look fine – until they don’t. A project that felt under control yesterday can quietly overspend today, without anyone noticing until the gap hits the bottom line. Project managers and teams aren’t missing targets because they don’t care. They’re missing them because they don’t have early, visible signals that something’s drifting off course.

That’s where the Cost Performance Index comes in. CPI turns financial performance into something you can see and act on before it becomes a problem. It provides leaders with a way to measure cost efficiency in real-time, not just in hindsight. Whether you’re tracking timelines in product development or trying to keep a strategic initiative within scope, cost performance index gives you the operational signal you need to adjust early, and with confidence.

Let’s unpack what CPI tells you and why it matters to teams running complex, high-stakes projects. Read on to get the practical guidance on how to apply it in a way that drives better outcomes.

Cost Performance Index Definition Explained in Simple Terms

The cost performance index is a ratio that measures the financial efficiency of a project.

At some point, every project manager faces the same internal question – are we getting enough value out of what we’ve already invested? The CPI brings structure to that question by turning it into a precise ratio: earned value divided by actual cost.

Mathematically, the CPI is calculated using the formula:

Cost Performance Index Formula = Earned Value (EV) ÷ Actual Cost (AC)

  • If the CPI is greater than 1, you’re delivering more than you’ve spent.
  • If the CPI is exactly 1, your project is exactly on budget.
  • If the CPI is less than 1, you’re losing efficiency, and the gap between effort and return is widening.

CPI measures budget adherence, it tells the truth about performance velocity: how fast your spend is converting into real, measurable progress. For project leaders, that truth is non-negotiable.

Earned Value Management

Earned Value Management (EVM) earns its place as a project manager’s and leader’s tool. EVM integrates scope, schedule, and cost into a single operational view, so you can measure progress against what was planned.

At the heart of EVM is the cost performance index, a live read on whether your financial inputs are translating into actual value. Used consistently, CPI and its EVM counterparts help project leads move from reactive problem-solving to proactive control.

For teams managing complex marketing programs, whether it’s internal creative delivery or multi-stream campaigns, EVM builds the discipline to align effort with intent and performance with expectation.

To explore this further, Dr. Mike Clayton, founder of OnlinePMCourses.com, offers a comprehensive introduction to Earned Value Management for project managers in a short video on his website.

Why Is Cost Performance Index Important in Project Management?

Picture a sprint review. The room’s quiet, but the questions land hard: “Are we still within range?” “How far off are we, really?” The numbers on the slide aren’t telling the full story, and leadership knows it.

This is where CPI sharpens the team’s focus.

A CPI gives project managers the visibility they need to make timely, measured decisions by translating raw cost data into a real-time efficiency signal. The conversations move from reactive clean-up to proactive course correction.

CPI is equally valuable to marketing operations and in-house agency teams. When work is fragmented across channels, teams, and tools, CPI offers a shared language for cost efficiency.

Within Earned Value Management, CPI seamlessly links cost, schedule, and scope into a coherent, operational model. As a result, it supports forecasting, risk assessment, and prioritisation. When used early and often, CPI informs Estimate at Completion (EAC) and, in turn, strengthens financial agility across programs – ultimately allowing teams to adjust course with confidence.

Cost Performance Index vs Schedule Performance Index (SPI): What’s the Difference?

Now your team is focused. You are accurately tracking the financial efficiency of projects. But if you’re only tracking one dimension, you’re not managing risk – you’re gambling with it.

CPI shows how efficiently you’re converting cost into value. Schedule Performance Index (SPI) tracks whether that value is arriving on schedule. They measure different truths, but they’re most powerful when read together.

  • CPI answers: Are we spending our budget wisely?
  • SPI answers: Are we delivering work on time?

Both metrics are crucial for a balanced view of project health. Used side by side, CPI and SPI surface operational drift early. They help you spot where progress is uneven, giving you the edge, so you can intervene before the impact hits stakeholders, delivery, or credibility. Project management provides further analysis on cost and schedule forecasting formulas that guide readers to better resource planning and project profitability.

How to Calculate the Cost Performance Index

You need to know if what’s been delivered is worth what’s been spent. It’s project review time, and a colleague pulls up the budget tracker. The numbers look close, but “close” isn’t a decision-making metric. That’s what the Cost Performance Index tells you. And calculating it is straightforward; once mastered, it becomes an indispensable tool for evaluating your project’s financial health.

CPI Formula Explained

The formula for calculating the Cost Performance Index is:

CPI = Earned Value (EV) ÷ Actual Cost (AC)

  • Earned Value (EV): The value of the work completed to date, usually expressed in monetary terms.
  • Actual Cost (AC): The actual amount spent to complete that work.

Example:

  • If your project’s Earned Value is $75,000 and the Actual Cost is $100,000:
    CPI = $75,000 ÷ $100,000 = 0.75

In this case, the CPI is 0.75, indicating the project is running over budget.

Let’s make it real:

Scenario 1: Project Under Budget

You’ve delivered $120,000 worth of work, spending just $100,000.

  • Earned Value (EV): $120,000
  • Actual Cost (AC): $100,000
  • CPI = 120,000 ÷ 100,000 = 1.2

A CPI of 1.2 means the project is highly cost-efficient. The team’s outperforming on cost – something to understand, not just celebrate.

Scenario 2: Project Over Budget

The team has delivered $90,000 of work, but it cost $120,000.

  • Earned Value (EV): $90,000
  • Actual Cost (AC): $120,000
  • CPI = 90,000 ÷ 120,000 = 0.75

A CPI of 0.75 signals that for every dollar spent, you’re only delivering 75 pence worth of value. That’s not sustainable.

Scenario 3: Project On Budget

Both EV and AC are $100,000.

  • Earned Value (EV): $100,000
  • Actual Cost (AC): $100,000
  • CPI = 100,000 ÷ 100,000 = 1.0

You’re on budget today. But if velocity shifts or scope creeps, that balance won’t hold.

Try a CPI Calculator

Use the vCalc.com’s online CPI calculator to determine your CPI quickly.

Interpreting CPI Results: What Do the Numbers Really Mean?

It’s one thing to run the math. It’s another to sit in front of a stakeholder and explain what it means for next quarter.

CPI gives you a signal, not a verdict. A strong number doesn’t always mean strong performance. A weak one doesn’t always mean failure. The value lies in context. It depends on how you read the signal, how fast you respond, and how well you align action to insight.

When CPI Is Greater Than 1: You’re Under Budget. That Doesn’t Mean You’re Safe.

The team delivered more value than expected for every dollar spent. At face value, that’s a win. But here’s the nuance: a strong CPI without schedule alignment or stakeholder clarity can still create drag.

As the project manager, you need to ask the hard questions. Is the timeline still intact? Does are delivery quality hold up under reduced spend? Is the “under budget” result due to efficiency or simply under-execution?

Treat a high Cost Performance Index as momentum. Use it to reinvest in high-leverage activities or accelerate delivery without compromising scope.

When CPI Is Below 1: It’s Not Just About Cost—It’s About Control

A CPI under 1 means you’ve spent more than you’ve earned in value. It shows up as budget pressure, missed expectations, and eventually, loss of leadership trust. It’s time to course correct.

This is where operational maturity matters. Use CPI as your recalibration point, not a post-mortem. Diagnose the root: inefficient resourcing, scope drift, or inaccurate forecasting.

  • Reassess Resource Allocation: Are you using high-cost resources inefficiently? Review
  • Project Scope: Have there been unapproved scope changes inflating costs? Reforecast
  • Remaining Work: Use the current CPI to project final cost performance and make adjustments early.
  • Engage Stakeholders: Proactively communicate the situation and share your recovery plan.

Then model forward using current CPI to revise your Estimate at Completion – a fast path to restoring predictability.

And don’t wait to surface the issue. Transparency buys time. Sharing a well-articulated plan early often carries more credibility than last-minute damage control.

Best Practices for Using CPI to Guide Project Decisions

You don’t win projects by reporting numbers. You win by translating those numbers into timely, confident decisions.

CPI’s value peaks when it’s operational. That means tracking it at meaningful checkpoints, not just at project close. CPI will become a living metric for your team. One that surfaces inefficiencies, supports earned value forecasting, and brings clarity to executive conversations about what’s working, what’s drifting, and what needs immediate course correction. If you can see it, you can solve it.

The rule is simple: act early. A declining CPI is less damaging than a delayed response to it.

  • Monitor Regularly: Review CPI at key project milestones regularly.
  • Use in Combination with SPI: Pairing CPI with SPI gives you a complete picture of time and cost performance.
  • Implement Earned Value Forecasting: Leverage your CPI to forecast final project costs using the Estimate at Completion metric.
  • Act Early and Decisively: CPI trends are most valuable when acted upon quickly; delays in corrective action reduce the chances of recovery.

Common Mistakes When Using Cost Performance Index (And How to Avoid Them)

CPI without scope control is a false signal

If your team adjusts the scope mid-project but doesn’t adjust the budget baseline, CPI turns into noise. The ratio might look solid, but it’s no longer tethered to reality.

What to do: Every scope change needs a documented impact on budget, timeline, or both. Realign baselines as you go, not retroactively.

CPI in a vacuum doesn’t tell the full story

You might be under budget, but if SPI is trending down, that cost efficiency is coming at the price of delivery delays. These delays carry their own cost, especially in marketing timelines tied to launches or quarterly targets.

What to do: Treat CPI and SPI as a package. Review them side by side. Then layer in stakeholder sentiment and delivery quality to get a complete picture of health and risk.

High CPI can mask underperformance

On paper, it looks like you’re winning. But a CPI over 1 without meaningful output can signal that you’re simply under-delivering.

What to do: Interrogate the result. Is the surplus from smart execution or from stalled activity? Validate cost efficiency against real progress and quality benchmarks.

Delayed response to a low CPI drains recovery options

This is where leadership discipline shows up. Many teams see a CPI dip and hope it’s temporary. But cost inefficiency rarely self-corrects. That dip can accumulate until mitigation becomes impossible without cuts or concessions.

What to do: Set hard CPI thresholds. When they’re hit, trigger a structured review. Build confidence by showing you’re not just tracking issues but acting on them with speed and clarity.

What the Cost Performance Index Looks Like in the Real World

It’s one thing to understand CPI in theory. It’s another to see how it plays out when timelines tighten, budgets contract, and leadership needs answers.

When used well, CPI gives decision-makers the data clarity to act with precision and the foresight to course-correct before the fallout hits.

Case 1: Digital Transformation at a Global Financial Institution

A large-scale programme aimed to replace legacy systems with cloud-based infrastructure. Halfway in, costs surged.

Challenge:

  • CPI dropped to 0.82 within six months
  • Budget overruns were accelerating, with no immediate output gains

Root Causes:

  • Integration complexity wasunderestimated
  • Heavy use of external consultants inflated delivery costs

Actions Taken:

  • Reallocated non-critical work to internal teams
  • Refocused scope on high-impact deliverables
  • Deprioritised lower-value features to reduce drag

Outcome:

  • CPI recovered to 0.98 within three months
  • Project closed inside acceptable budget variance

Key Insight:

Early action sets clear priorities and the confidence to pivot when the data demands it.

Case 2: Commercial Office Development Amid Market Volatility

A construction firm managing a large office build noticed a dip after months of stable financial performance.

Challenge:

  • CPI slipped from 1.05 to 0.92 mid-phase
  • Rising costs risked triggering delays and margin erosion

Root Causes:

  • Unexpected material price increases
  • Labour shortages led to costly subcontractor overtime

Actions Taken:

  • Renegotiated material supply contracts to regain control
  • Adjusted build phasing to optimise available labour
  • Introduced weekly cost-efficiency checkpoints to stay ahead of future drift

Outcome:

  • CPI climbed back to 1.02
  • Project delivered slightly under budget

Key Insight:

Even efficient projects aren’t immune to volatility – what matters is how quickly you catch the signal and act on it.

Whether managing complex digital programmes or large infrastructure projects, CPI provides project leaders with a clear line of sight into cost efficiency – empowering better decisions, faster interventions, and ultimately, more successful project outcomes.

Tools and Techniques to Improve Your Project’s CPI

It’s one thing to measure CPI. It’s another to improve it – especially when teams are already stretched, timelines are tightening, and execs are scanning for signals that things are under control.

Strong project leads know that cost performance doesn’t improve with tighter spreadsheets. It improves with earlier foresight, better resourcing, and systems that connect effort to impact.

Forecasting and Budget Adjustments

When paired with forward-looking tools, CPI becomes a mechanism for anticipating cost pressure before it compounds. Leaders who forecast early can avoid issues altogether.

  • Rolling forecasts help you keep budget assumptions current.
  • Review and refine at defined checkpoints.
  • Estimate at Completion (EAC) lets you model the end-state based on current CPI, so decisions are made with clarity.
  • Scenario planning gives your team the space to ask “what if” while you still have room to adjust.

Resource Allocation and Optimisation

Right resource, right task, right moment. That’s the multiplier.

One of the most common causes of a declining CPI is misalignment. The wrong people doing the wrong work for too long without being challenged.

  • Run resource utilisation reviews monthly. Spot where capacity is misapplied or stretched too thin.
  • Balance internal and external delivery based on velocity. Specialist contractors can unlock speed – but only if their impact outweighs their cost.
  • Prioritise high-leverage deliverables. Projects drift when time is spent on what’s easiest to deliver and not what’s most valuable to the outcome.

Want to go deeper on aligning teams to the right work at the right time? This resource allocation guide breaks down how to deploy people where they’ll have the greatest impact

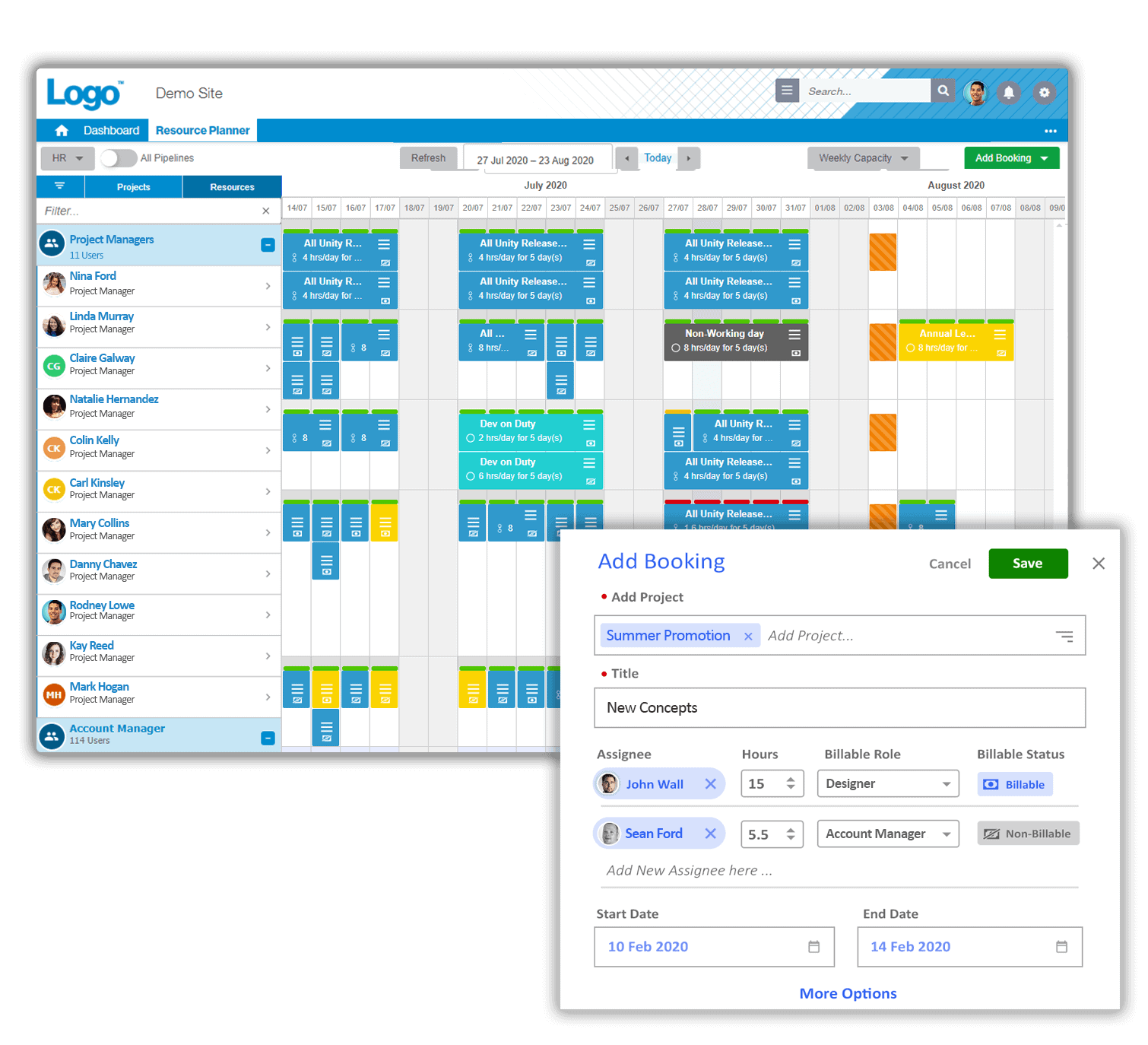

Streamlined project management software interface with calendar view and task scheduling.

Leveraging Project Management Software

Manual CPI tracking works – until it doesn’t. The moment complexity scales, leaders need systems that work in real time.

  • Choose tools with built-in Earned Value Management so CPI and SPI are calculated and surfaced automatically.
  • Connect cost tracking and delivery planning. You’re already behind if your financial and project timelines live in separate systems.
  • Use visual dashboards as leadership tools. The faster you see a variance, the faster you can move.

Technology will show you what’s happening, while there’s still time to fix it.

Need help managing project costs more effectively? Explore how Screendragon’s project management software makes your work flow with hyper-efficiency.

Frequently Asked Questions (FAQ)

What is a good Cost Performance Index (CPI)?

A CPI of 1.0 means you’re exactly on budget. That’s your baseline.
Anything above it? You’re delivering more value than you’ve spent. But context matters. A high CPI could reflect smart execution, or it might reveal under-resourcing that’s slowing progress elsewhere.

When a CPI is below 1, this signals you’re over budget. The number alone won’t fix it, but it tells you where to look.

How does CPI relate to project profitability?

Profit margins don’t erode all at once – they’re chipped away slowly by cost inefficiency. CPI helps you spot that erosion early. A higher CPI means each dollar spent is generating more output, which creates financial headroom. Over time, that efficiency compounds.

Track it consistently. CPI won’t guarantee profitability, but it will protect it.

Can CPI predict future project performance?

Yes, but only if you use it as a leading indicator. Paired with Estimate at Completion (EAC), CPI gives you a running view of likely total cost based on current trends. That forecast helps teams re-scope, re-phase, or reallocate before things drift further off course.

What is the difference between CPI and SPI?

CPI answers: Are we spending wisely?
SPI answers: Are we moving fast enough?

Together, they tell a story about whether your project is both efficient and progressing as planned. Used in isolation, each can be misleading. Used together, they help you lead with precision.

How often should CPI be reviewed?

At every major milestone. But also, whenever direction shifts, risks surface, or scope evolves. CPI is not a tool just for scoring project and marketing activities. Frequent, structured check-ins make it a tool for steering.

Conclusion

Every leader’s had the moment: numbers on the screen, timeline in flux, a room full of stakeholders waiting for certainty. The question isn’t just “Are we on budget?” It’s “Do we still have control?”

In today’s environment, margins are thinner, expectations are higher, and visibility is non-negotiable. That’s when you learn how CPI isn’t a nice-to-have metric. It’s a financial steering wheel. And it only works if you’re willing to use it in real time.

Understanding CPI is one thing. Applying it at the right moment, with the right context, is what separates reactive management from operational leadership. Whether you’re stabilising a high-risk initiative or squeezing more value from a well-oiled program, CPI gives you the data language to act with confidence and prove value under pressure.

Because cost efficiency isn’t about spending less. It’s about making every dollar spent work harder, smarter, and faster.
